Canadian enterprise budgeting reference
A professional drone program costs more than the aircraft. This guide’s six Canadian examples range from C$7,500 to C$82,579 for acquisition, setup and selected first-year support—before tax and routine mission labour. They are illustrations, not market averages or complete operating budgets.
The useful number for approval is the cost of delivering your organization’s work. Start with a dated, configuration-specific equipment quote. Add deployment, annual operating costs and the staff hours required to produce accepted results. A docked system also needs a site-specific installation and operating plan; its hardware subtotal cannot stand in for that plan.
In this budget reference
- Define the budget boundary
- Current price anchors
- Six worked mission budgets
- Dock deployment costs
- Certification and compliance
- Labour and delivery capacity
- Three-year ownership model
- Annual renewals and reserves
- Buy, rent or subcontract
- Ninety-day approval plan
- Quote and budget checklist
- Budget questions answered
Start with scope
01What does “program cost” include?
A program budget needs three views: purchase cost, cash required to operate, and the value of internal capacity consumed. They answer different questions. Combining them without labels can make one proposal appear cheaper simply because it leaves payroll, processing or site work elsewhere.
Define the mission before selecting the aircraft: the sites, operating conditions, accepted deliverable, accuracy or image requirement, annual volume and who will use the result. A construction progress model, a radiometric thermal report and a classified LiDAR point cloud do not require identical field or processing resources. A visual inspection image is not automatically a survey deliverable.
What must be acquired?
Aircraft, payload, batteries, charging, positioning equipment, initial software, computer and field kit. Identify what the bundle already contains.
What must be funded?
Purchases and deployment, plus renewals, insurance, travel, repairs, consumables and any additional paid staffing or contractor invoices.
What work does it consume?
Existing employees’ planning, flying, processing, quality review and administration. These hours may not require new cash, but they are not free.
Record existing assets separately. Reusing a workstation can reduce incremental cash, but only after a representative dataset confirms that it meets the workload. The same applies to an existing GNSS receiver, processing licence or pilot certificate. “Already owned” is a purchasing fact, not evidence that the asset is suitable or that someone has capacity to use it.
Make the budget period explicit. “Year one” can mean twelve months after deployment, a short remaining fiscal year or a full calendar year. Show when payment, activation, training and the first accepted project occur. Seasonal teams should model the working season and the off-season obligations, not divide an uncertain annual forecast into twelve identical months.
Dated purchase evidence
02Current Canadian price anchors
These SpeedyDrone public prices were checked on October 6, 2026. They anchor a calculation; they do not establish a complete installed cost, guaranteed stock or a universal recommended configuration. An orderable listing is not proof of physical stock. Confirm the selected variant, availability, shipping date and quote validity before approving a deployment schedule.
Price ledger · Scroll horizontally on phones to read the complete configuration notes.
| Exact item | Public anchor | Budget boundary and purchase source |
|---|---|---|
| DJI Matrice 4E Mission Edition | C$6,832 | Compact mapping bundle with three batteries and a landing pad. Positioning, processing and independent accuracy checks need their own scope. |
| DJI Matrice 4T Response Edition | C$11,620 | Thermal/response bundle with three batteries, speaker, spotlight and landing pad. Do not add those included items again. |
| Matrice 400 SP Plus Full Package | C$15,724 | Includes controller, DJI Care Enterprise Plus, BS100 station and one TB100 battery. The mission payload is a separate purchase. |
| Zenmuse H30T — SP variant | C$13,647 | Zoom/thermal multi-sensor payload. Care variant changes the price; contact SpeedyDrone to confirm availability. |
| Zenmuse L3 | C$22,073 | Matrice 400 LiDAR payload. Its dedicated single-gimbal connector must be specified and priced. |
| TB100 Intelligent Flight Battery | C$2,187 each | Additional Matrice 400 flight battery. Two extra batteries cost C$4,374, above the one in the package. |
| D-RTK 3 Multifunctional Station | C$2,621 | A base-station/correction option. A network correction service may be another workflow; validate coverage and deliverable requirements. |
| D-RTK 3 Survey Pole and Tripod Kit | C$742 | Separate station-support accessory. Station plus pole/tripod is C$3,363. |
| DJI Terra Standard — Permanent variant | C$7,519 | Exact displayed Permanent option, not the lower-priced 1 Year option. Confirm edition, activation, device binding and update entitlement in writing. |
| DJI Dock 3 | C$19,408 | Remote-operations dock. Aircraft, site works, network, software and operational approval are separate scope items. |
| DJI Matrice 4D | C$9,596 | Visible-light mapping aircraft in the Dock 3 family. This standalone listing states that the battery is not included. |
| DJI Matrice 4TD | C$12,199 | Thermal aircraft in the Dock 3 family. This standalone listing also excludes the flight battery. |
| DJI Agras T50 Pro Package (3 Batteries) | C$29,999 | Agricultural aircraft/battery bundle. Refill, power, transport, application training and permission are not an installed farming system. |
| Advanced Drone Pilot License with Flight Training | C$650 | AlteX ground school, hands-on training and flight review. Federal charges and employees’ attendance/travel time are separate. |
| DJI Enterprise Certification | C$1,299 | Equipment and mission-workflow training. It does not replace the applicable Transport Canada pilot certificate. |
Prevent bundle and licence double counting
Use the exact package contents, not the product-family name, to prepare a bill of materials. A charging station already supplied with the aircraft should not become a second purchase line unless a second station is genuinely required. Likewise, distinguish batteries included, extra batteries purchased now and batteries forecast for later replacement.
The current Terra Standard listing has a lower-priced “1 Year” variant while its descriptive copy and DJI’s current FAQ describe Standard as perpetual. This guide does not treat that mismatch as a confirmed annual Standard licence offer. Ask for the exact edition and term. The Permanent price above is a dated listing anchor, not a promise of unlimited future updates, support or unrestricted device transfers.
Separate equipment care from aviation liability insurance. Check covered aircraft and payloads, term, renewal, deductible, shipping and service exclusions. An included protection plan can reduce duplicate purchase lines without eliminating a downtime plan or a broker’s insurance assessment.
Worked examples, not market averages
03Six mission budgets you can reproduce
The examples combine the dated prices above with explicitly chosen allowances. Each range is the sum of its listed low or high inputs, not a survey of Canadian program spending. They cover acquisition, setup and selected first-year support. Routine mission payroll, internal staff capacity, project travel and operating consumables are excluded unless a line explicitly includes them. Add those from your delivery forecast, and add applicable tax.
Content and visual documentation: C$7,500–18,300
This illustrative starter scope assumes a C$3,000–6,000 aircraft/three-battery kit, C$750–1,300 training and administration, C$500–1,500 field accessories, C$1,500–5,000 workstation/storage, C$750–2,500 first-year insurance and C$1,000–2,000 contingency. None of these allowance bands is a supplier quote. Select equipment only after confirming the required image format, working distances and operation category.
Use this scope for marketing or visual records, not for promising engineering measurement. Editing, client revisions, music or media licences, travel and business development require separate operating lines. An existing suitable computer can reduce new spending; a new camera aircraft does not create an enterprise data workflow on its own.

View at SpeedyDrone →

View at SpeedyDrone →
Matrice 4E mapping: C$19,390–32,890
The C$10,195 core combines the Mission Edition with D-RTK 3 and its pole/tripod. That is one chosen correction workflow, not a requirement to buy a base for every project. Matrice 4E’s mapping-oriented wide camera has a mechanical shutter; budget control/checkpoints and deliverable review independently of that acquisition capability.
Reproducible mapping example · Scroll to see both allowance columns and the classification.
| Line item | Low CAD | High CAD | Evidence type / scope |
|---|---|---|---|
| Aircraft + correction kit | 10,195 | 10,195 | Verified listing prices: 6,832 + 2,621 + 742 |
| One pilot’s training + federal charges | 695 | 695 | 650 course + 10 exam + 25 issuance + 10 aircraft registration; successful first attempt |
| Processing licence | 3,000 | 8,000 | Editable allowance; obtain exact edition/term quote |
| Control, targets and field kit | 1,000 | 3,000 | Editable allowance; excludes paid field-crew hours |
| Workstation + storage | 2,000 | 5,000 | Editable allowance; test dataset before deciding |
| First-year insurance | 1,000 | 3,000 | Illustrative allowance, not a broker premium quote |
| Unallocated contingency | 1,500 | 3,000 | Editable uncertainty allowance, not expected expense |
| Example subtotal | 19,390 | 32,890 | Before tax, routine mission labour, travel and consumables |
Reduce this subtotal only by documenting a genuine substitution or existing asset. Removing independent checkpoints to fit a hardware budget can leave the organization unable to demonstrate the deliverable’s accuracy. Processing time, coordinate-system work and the person qualified to accept the result belong in the operating forecast.
Matrice 4T thermal/response: C$18,065–27,315
Start with C$11,620 for the Response Edition and C$695 for one new pilot’s course/federal charges. Add assumed C$500–2,000 software/reporting, C$750–2,000 field kit, C$1,500–4,000 workstation/storage, C$1,500–4,000 insurance and C$1,500–3,000 contingency. These inputs sum to the stated subtotal; the included speaker, spotlight and batteries are not purchased again.
A search-and-rescue team may prioritize readiness and live decision support. A building or electrical inspection team may need repeatable thermal conditions, radiometric analysis and qualified interpretation. Fund the appropriate mission training and review rather than treating every thermal image as a defensible diagnosis. Additional pilots, radios and IT integration expand the scope.

The platform package includes one flight battery and charging station. The mission sensor, extra rotation batteries and processing system determine the rest of the budget.
View at SpeedyDrone →Matrice 400 + H30T inspection: C$45,739–65,739
The C$33,745 equipment core is C$15,724 platform + C$13,647 H30T SP + two additional TB100 batteries at C$4,374. DJI’s current H30 Series FAQ confirms Matrice 400 compatibility with the required current firmware. The H30T provides visible-light, thermal and ranging capabilities; it is not a LiDAR mapping payload.
Add C$1,994 for the listed enterprise course, Advanced training course and C$45 federal charges. Other example allowances are C$2,000–8,000 software/communications, C$1,000–4,000 field equipment, C$2,000–6,000 workstation/storage, C$2,000–6,000 insurance and C$3,000–6,000 contingency. Crew requirements, actual dataset review and standby commitments still need a separate labour forecast. This is not an emergency-response service-level guarantee.
Matrice 400 + L3 LiDAR: C$60,579–82,579
The C$45,534 core includes the platform, L3, two extra TB100 batteries and D-RTK 3/pole/tripod. Add assumed C$2,000–5,000 connector/field equipment/media, C$5,000–12,000 processing licence/workstation/storage, C$3,000–8,000 training/control/QA services, C$2,000–6,000 insurance, C$3,000–6,000 contingency and C$45 federal charges. The connector allowance is not a verified connector price; obtain the exact quote before ordering.
DJI specifies Matrice 400 and the dedicated L3 single-gimbal connector. Confirm that the connector, media, processing entitlement and coordinate-system workflow are in the procurement scope. Budget point-cloud classification, validation and the final GIS/CAD handoff. Manufacturer collection capability does not establish a Canadian flight permission, an accepted accuracy specification or a billable daily production rate.

The three-battery package anchors the agricultural example. Support equipment, the operating crew and application permissions remain separate budget decisions.
View at SpeedyDrone →Agras T50 agricultural support setup: C$41,999–60,999
This example starts with the C$29,999 three-battery Pro Package and adds assumed C$5,000–15,000 support/power/refill/transport equipment, C$2,000–5,000 training/administration, C$2,000–5,000 insurance and C$3,000–6,000 contingency. It excludes purchasing a vehicle or land, chemicals, paid seasonal mission crews and operating fuel/consumables. Verify package inclusions before adding chargers or other equipment.
Budget spraying and spreading as different workflows. Chemical mixing/loading, protective equipment, cleaning, water handling and seasonal support can materially change spending. Aviation permission and pesticide permission are separate. Health Canada’s June 2026 SPN2026-02 allows eligible aerial-labelled pesticide uses under specified conditions; it does not authorize every product or every provincial operation. Confirm the actual label, policy restrictions and provincial/territorial requirements before forecasting spray revenue.
Installation is a separate project

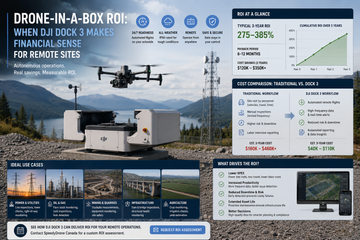

04Dock 3 needs a site-based budget
Dock 3 plus the listed Matrice 4D is C$29,004; with Matrice 4TD it is C$31,607. These are two-item public price sums, not operational deployment totals. The standalone aircraft listings exclude the flight battery. Confirm a complete dock/aircraft configuration rather than assuming that combining two catalogue prices produces a ready-to-operate site.
A dock shifts work from travelling to launch every mission toward commissioning, remote supervision and keeping the site available. It does not eliminate staff, network costs, weather interruptions or local maintenance. Budget who will respond when the aircraft cannot return normally, the network is unavailable or the installation needs physical attention.
- Site assessment and mounting: property consent, clearances, roof/ground engineering, access, drainage, snow accumulation, barriers and security. Identify which contractor owns each task.
- Power and connectivity: electrical supply, surge protection, wired/cellular service, firewall approval, backup arrangements and IT change control. Obtain both installation and recurring charges.
- Software and integration: mission-management licence, users, storage, live-streaming needs, data export, APIs and any internal-system work. Confirm what is included rather than assuming a single software fee covers every workload.
- Commissioning and operations: route validation, emergency procedures, pilots, remote supervision, site visits, maintenance response and replacement arrangements. Define an acceptance test and who signs it.
A planned BVLOS workflow needs the applicable Canadian pilot, operator, aircraft and operational eligibility. Buying a dock does not grant it. Establish feasibility before civil work or a long-term service commitment. For the separate return-on-investment question, use the Dock 3 remote-site ROI guide; use this resource to build and reconcile the cost inputs.
Canada-specific inputs
05Separate federal fees from readiness costs
The applicable operation category depends on what, where and how you fly, not simply whether you charge a customer. Determine it before selecting training or quoting a project. Exam charges are small compared with a team’s training time, flight reviews, procedures, site surveys and continuing competence.
Official fee inputs · Scroll to read applicability; not every line applies to every program.
| Federal item | CAD fee | Budget treatment |
|---|---|---|
| Aircraft registration | 10 | Per required aircraft registration; confirm the aircraft/operation rules. |
| Basic or Advanced online exam | 10 per attempt | CAR fee schedule; retakes add charges and study time. |
| Advanced certificate issuance | 25 | Separate from exam, private training and flight review. |
| Level 1 Complex exam / certificate | 50 / 125 | Applicable qualifications and review requirements are additional. |
| RPAS Operator Certificate | 125 | Organization-level certificate; procedures and organizational work cost more than the fee. |
| SFOC-RPAS application | 20 / 75 / 900 / 2,000 | Very low / low / medium / high complexity; applicable exceptions and preparation work are separate. |
Fee sources: current Canadian Aviation Regulations Schedule IV and Transport Canada’s fee-change summary in the sources below. Checked October 6, 2026.
The examples’ C$45 federal amount assumes one aircraft registration, one successful Advanced exam and one Advanced certificate issuance. It is not a universal program licence fee. A second pilot, a retake, a different operation or an already-qualified employee changes the calculation. The C$650 training course includes a private flight review; do not add another review invoice for the same included service.
Record legal qualification and practical mission competence separately. A pilot may hold the applicable certificate and still need equipment, thermal-analysis, mapping or emergency-procedure training. Include paid attendance, travel and supervised practice in the capacity plan, even when the course invoice is already in the startup budget.
For lower-risk BVLOS, assess the applicable Level 1 Complex, RPOC and aircraft/operation requirements. Other operations may need an SFOC. This budget reference does not determine your legal eligibility. Complete the operational review using the Canadian professional-drone deployment guide before spending on the assumption that a particular site or flight is permitted.
Measure the complete job
06Budget staff-hours, not flight-hours
A flight-time forecast is not a labour forecast. Add each person’s work from scoping to accepted delivery. Two employees travelling together for two hours consume four staff-hours. Processing can consume computer time and analyst time differently; do not charge a full day of analyst labour simply because a computer runs unattended all night.
Use a loaded hourly rate supplied by your organization: compensation, employer costs and the agreed allocation of relevant overhead. Do not use the customer billing rate as if it were payroll cost. For an existing salaried team, report capacity consumption separately from additional cash required to hire staff or pay overtime. When new payroll is already in the cash forecast, do not add it again as an economic-cost adjustment.
Illustrative staffing build · The C$60 hourly rate is an assumption, not a Canadian wage benchmark.
| Work stage | People × hours | Staff-hours | At C$60/hour |
|---|---|---|---|
| Planning / permissions | 1 × 2 | 2 | C$120 |
| Travel / setup | 2 × 2 | 4 | C$240 |
| Field capture | 2 × 2 | 4 | C$240 |
| Processing / QA | 1 × 6 | 6 | C$360 |
| Delivery / records | 1 × 4 | 4 | C$240 |
| One accepted job | Sum of all roles | 20 | C$1,200 |
At 24 accepted jobs per year, this example uses 480 staff-hours and C$28,800 of internal capacity annually. Additional practice, management, maintenance and failed attempts must be added if they are outside those 20 hours. A backup pilot or analyst can protect continuity but requires its own qualification and availability plan.
The denominator is accepted work—not flights completed.
Track attempted missions, accepted deliverables, rework hours, cancellation reasons and turnaround time. Weather, access, vegetation, inadequate image coverage or a client’s changed scope can reduce output without reducing fixed ownership cost. Agree what “accepted” means before estimating cost per job: a flight log, a model that opens and a verified engineering dataset are different outputs.
Cash and capacity reconciled
07A transparent three-year cost model
Calculate three-year external cash as upfront acquisition/deployment plus each year’s operating payments and replacement purchases, less realized residual proceeds. Then add internal capacity not already included in those payments to show an economic-cost view. This simple undiscounted model is for planning; it is not an accounting profit calculation or a financing schedule.
The following independent illustration assumes C$20,000 upfront, C$6,000 annual non-payroll operating cash, a C$3,000 replacement purchase in year three and C$3,000 resale proceeds at the end. It also assumes 24 accepted jobs annually at 20 staff-hours each and C$60/hour. These round numbers are chosen inputs, not a quotation for one of the packages above.
Annual funding view · Resale is shown separately so it does not conceal year-three payment requirements.
| Cost view | Year 1 | Year 2 | Year 3 | Three years |
|---|---|---|---|---|
| Gross external cash | C$26,000 | C$6,000 | C$9,000 | C$41,000 |
| Internal staff capacity | C$28,800 | C$28,800 | C$28,800 | C$86,400 |
| Resale proceeds | C$0 | C$0 | − C$3,000 | − C$3,000 |
| Net economic cost | C$54,800 | C$34,800 | C$34,800 | C$124,400 |
With 72 accepted jobs over three years, the example is C$1,727.78 per accepted deliverable. If the same total spending produces only 18 accepted jobs each year, the denominator falls to 54 and the cost becomes C$2,303.70. That change is about utilization and acceptance, not a change in the aircraft’s sticker price. Include extra rework spending if the lower output also increases cost.
For a cash view, include invoices and incremental payroll actually requiring funding. For an economic view, include the relevant internal resource cost. Do not add depreciation to a model that already counts the full acquisition as cash. If financed, prepare a separate payment schedule: adding both the full purchase and loan principal repayments overstates cash cost. Interest, fees and the timing of taxes need their own treatment.
Run at least one less favourable operating case before approval. Use fewer accepted jobs, slower analysis, delayed commissioning or an unavailable key employee. Keep a conservative residual assumption; an expected resale price is not money available to pay a repair invoice today.
Year two still needs funding
08Build renewals, reserves and data into operations
Replace broad annual spending bands with quantities, service terms and named owners. An annual software subscription is one renewal; a perpetual purchase is an upfront item with separately confirmed updates or support. Seats, processing capacity, storage, integrations and online/offline requirements can have different charging bases.
For a LiDAR workflow, confirm software compatibility using representative sensor data, then test processing time and export quality on the proposed workstation. Do not assume a licence alone includes CAD/GIS tools, classification labour or client hosting. For remote operations, specify mission-management, connectivity and storage scope separately from the acquisition package.
Insurance is not required for standard operation categories under Transport Canada’s current guidance, but it is recommended; proof may be needed for an SFOC. Clients, property owners or procurement policy can impose additional requirements. Obtain a broker quote for the actual operation, territory, aircraft value, liability limits and exclusions. Do not present a chosen allowance as an industry-average premium.
Build a maintenance and battery plan from the fleet’s use, care terms, inspection schedule and supplier information. A percentage reserve is a management assumption, not a manufacturer replacement requirement. Distinguish cash held for a possible repair from an actual invoice and reconcile unused contingency later. Counting a reserve and the same expected repair as separate expenses inflates the forecast.

The sensor is one acquisition line. Its connector, processing, validation, media and accepted output specification belong in the same workflow budget.
View at SpeedyDrone →Data governance has costs beyond an SSD. Record data location, retention, backups, access control, restore testing and client handoff. An offline requirement can change licences and infrastructure; a cloud restriction can remove a convenient delivery option. Use the drone data-security procurement checklist to identify the evidence, then cost only the controls applicable to your program.
Keep tax cash and economic cost distinct. Eligible GST/HST registrants may recover qualifying commercial-use tax through input tax credits, subject to CRA requirements. Do not assume every organization or purchase qualifies. Show applicable tax in the funding plan and have your accountant confirm recoverability, asset treatment and financing implications. Provincial tax rules and the timing of recovery can change cash requirements.
Compare matching deliverables
09Buy, rent, subcontract or finance?
Ownership fits repeatable work when the organization has qualified people, processing capacity and a funded operating plan. Renting can cover occasional capture or a temporary equipment gap, but it does not supply an analyst or remove operating obligations. Subcontracting can provide a completed deliverable; compare its scope, acceptance criteria, data ownership, turnaround and exclusions with the internal alternative.
A simple annual break-even illustration uses C$9,000 fixed ownership cost, C$650 internal variable cost per accepted job and a C$1,500 like-for-like subcontract price. The calculation is 9,000 ÷ (1,500 − 650) = 10.59, so at least 11 comparable accepted jobs are needed before the simplified owned-cost line is lower. These are invented planning inputs, not current service quotes. The fixed-cost assumption must include the capital allocation relevant to the comparison.
Rework, travel, standby, specialist review or an incomplete scope can invalidate that comparison. If the subcontract price is no higher than the internal variable cost, more volume will not recover fixed cost under this formula. Do not use a camera-rental daily rate as a proxy for a fully processed and accepted survey.
SpeedyDrone’s rental listings show available rental offerings, not guaranteed access to every enterprise aircraft or sensor. Confirm equipment, dates, deposit, insurance, permitted use and return conditions. A specialist subcontract needs its own proposal rather than an assumed SpeedyDrone service promise.
Financing and leasing information can support a funding discussion. Compare deposit, rate, fees, term, payment schedule, ownership/residual terms and early repayment conditions. Financing changes when cash is paid; it does not improve data quality, grant permission or prove demand. Keep approval and partner terms separate from the equipment decision.
Approval based on a real job
10A ninety-day plan with decision gates
Use the first deployment to measure a representative workflow before expanding a fleet. Ninety days is an illustrative planning sequence, not a promised permit, installation or supplier timeline. Set the actual schedule around site access, training, procurement and the working season.
-
Days 1–15: define acceptance
Agree the mission, site, users, deliverable, annual demand and who can approve data quality. Record operating and security constraints.
Gate: the proposed result solves a funded need.
-
Days 16–30: test one representative job
Use the proposed aircraft/sensor and processing route. Measure each role’s hours, battery rotation, data volume and handoff.
Gate: the deliverable is usable under actual site conditions.
-
Days 31–45: reconcile the budget
Obtain itemized hardware, licence, insurance and site-work quotes. Replace allowances where evidence exists and retain identified unknowns.
Gate: year-one cash and three-year capacity are both funded.
-
Days 46–60: qualify and document
Complete applicable training, procedures, emergency arrangements and data responsibilities.
Gate: the team and operation are eligible and ready, not simply equipped.
-
Days 61–80: deliver and review
Complete a pilot project, capture rework and compare estimated with actual hours and spending.
Gate: an authorized recipient accepts the result and the support plan works.
-
Days 81–90: approve production scope
Decide whether to own, rent, outsource or adjust the system. Assign renewal, maintenance and performance owners.
Gate: the business case remains valid after the field evidence.
For recurring construction work, the construction progress-monitoring resource helps define a repeatable capture-to-delivery workflow. Use its operating structure to collect cost evidence; do not count every successful takeoff as a completed reporting cycle.
Make the quote comparable
11Procurement checklist and budget register
Send a supplier the operating problem and acceptance criteria, not only a model name. An itemized response is easier to evaluate when every line identifies what is included, excluded, recurring or dependent on another decision.
- Mission and location. Province, site count, airspace/operation assumptions, terrain, weather exposure, access and planned season. Identify docked, mobile or manually launched deployment.
- Deliverable and acceptance. Required imagery, thermal report, map, point cloud or media output; coordinate system, validation method, file formats, review owner and turnaround.
- Annual workload and people. Accepted jobs, expected attempts/rework, crew roles, existing certificates, analyst availability and travel. Show incremental hiring separately.
- Existing assets and constraints. Workstation, GNSS, software, vehicle, power, insurance and IT systems. Identify which assets have actually passed a workload test.
- Commercial scope. Exact package/variant, quantity, battery inclusion, licences/activation, care term, tax, shipping, availability, quote expiry and commissioning responsibilities.
- Operating ownership. Renewal dates, support route, downtime response, backup staff, data retention, budget owner and review date. Name unresolved items and who will price them.
Use one line-item register
For each cost, record an item ID, category, description/configuration, quantity, unit cost, source and checked date, payment year, recurrence, inclusion status, uncertainty and owner. Mark the evidence as verified public price, supplier quote, internal estimate or unresolved. An unknown installation cost is not a zero-cost installation.
Keep “included in another package” visible and exclude it from the sum. Give contingency its own line and explain what uncertainty it covers. Reconcile forecast replacements with repair reserves. For staff, use role, hours and loaded rate; keep flight-time statistics in an operating log, not as a substitute for that staffing build.
Review the register at quote expiry, before equipment substitution and after the first representative project. Assign actual spending and staff time to the same categories so the forecast can improve. Avoid automatically carrying an old price, annual licence term or insurance assumption into next year’s approval.
Budget questions answered
12Professional drone program cost FAQ
How much should a Canadian company budget in the first year?
Begin with a mission-specific scope rather than one nationwide “typical” figure. This guide’s compact mapping and thermal examples total C$18,065–32,890 before tax and routine mission labour. They combine dated product prices with chosen setup and support allowances, so they are not market averages. Add your actual crew time, travel, consumables, additional pilots and recurring workload. A docked installation requires a site quote. Reusing proven existing assets can reduce new cash, but internal staff still consume capacity. The approval number should show both incremental cash and the full delivery resource requirement.
Can I start with just a drone and add everything else later?
You can phase purchases, but the first mission still needs a complete safe and usable workflow. Confirm suitable batteries/charging, applicable qualification and permissions, field equipment, data processing and a recipient who can accept the result. Delay an optional spare or premium software feature only when its absence does not prevent the agreed deliverable. If demand is uncertain, a rental or subcontracted pilot project can reveal the real workload before fleet spending. Avoid buying a sensor first and discovering later that the computer, licence or review skills needed to use its data were never funded.
Does an RTK drone remove the cost of ground control and QA?
No acquisition feature alone proves the accuracy of a delivered dataset. RTK can support positioning, but the project still needs the right correction workflow, coordinate reference, capture conditions, processing and an appropriate independent validation method. The mapping example includes a base station as one selected option and a separate control/field-kit allowance. Replace those assumptions with a workflow demonstrated on representative terrain and a client-accepted specification. Budget the person and time required to inspect checkpoints and explain the result, not merely the equipment capable of receiving corrections.
Is liability insurance mandatory for all paid drone work?
Transport Canada’s current guidance says insurance is not required for standard operation categories, although it is recommended; proof may be required for an SFOC. Paid work alone is not the rule that determines your operation category. Customer contracts, property access or procurement policy may require coverage independently. Ask a broker about your actual aircraft, payload, territory and operations, then record the premium, limits, exclusions and deductible. Equipment care is a separate product and should not be treated as aviation liability coverage. The insurance allowances in this article are example inputs, not quoted premiums.
What makes a Dock 3 quote different from an aircraft quote?
A dock quote must connect equipment to a specific installation and operating model. Include the compatible aircraft and battery configuration, mounting/engineering, power, network, software, commissioning, site access and ongoing remote/local responsibilities. The aircraft’s standalone package can contain items that differ from an integrated dock proposal, so compare scope rather than adding prices blindly. Canadian operating eligibility is also independent of the hardware. A useful proposal defines acceptance tests, recurring charges and who responds to failures. The two-item hardware subtotal in this article is deliberately not called a complete deployment budget.
Should employee salaries be included in drone program cost?
Include the relevant work, but distinguish economic capacity from additional cash. An existing salaried employee may not increase this year’s payroll when assigned to drone projects, yet their planning, field and analysis hours displace other work. The three-year illustration adds that capacity separately because it is not already in its external cash lines. If the program hires a new employee and the payroll payments are already counted, adding those same hours again overstates cost. Agree the loaded-rate method with finance and capture actual role-by-role hours during the pilot project.
How do I avoid double counting software, care and batteries?
Use an exact configuration register with inclusion and recurrence fields. Record batteries supplied with the bundle, extras bought now and replacements purchased later as different decisions. Identify whether software is an upfront perpetual purchase, a subscription or a separately quoted update/support service. Check activation, device binding and the features actually licensed. Mark equipment care already included in a package and price only the additional coverage required. Keep reserves and actual expected repair invoices reconciled. A low starting price without variant, term and inclusions is not sufficient evidence for an annual budget.
How can I decide whether buying is cheaper than subcontracting?
Compare accepted deliverables with the same site access, quality checks, data ownership, turnaround and exclusions. Estimate fixed ownership cost and the variable cost of one internally delivered job, then compare a real subcontract proposal. The illustrative formula in this guide reaches a threshold of 11 jobs, but its prices are assumptions, not supplier evidence. If internal variable cost equals or exceeds the provider’s price, that simplified formula cannot justify ownership through volume. Test lower utilization and rework as well as the expected case. Readiness, continuity and control may matter even when the cheapest direct-cost option differs.
Sources and update method
13Check the inputs before approving spend
Public equipment and course prices link directly to their exact SpeedyDrone listings in the ledger. Those pages are purchase references, not independent evidence of typical program cost. All other budget bands, labour rates, utilization and residual values are explicitly chosen illustrations. Replace them with written quotes and your organization’s operating records.
- Canadian Aviation Regulations — Part I, Subpart 4, Schedule IV, items 26–31 for exam and certificate charges.
- Transport Canada’s current fee and rule-change summary — registration, RPOC and SFOC charges.
- Transport Canada operation categories and safe and legal operation guidance — applicability and insurance boundary.
- DJI Matrice 4 specifications, H30 Series FAQ, L3 FAQ and Dock 3 FAQ — camera and platform/configuration facts.
- DJI Terra FAQ — licence term, binding and update conditions; clarify the retail variant mismatch before ordering.
- Health Canada SPN2026-02 — June 2026 pesticide-application policy and its conditions.
- CRA input tax credits — eligibility and supporting-record requirements.
Information checked October 6, 2026. Recheck prices, configuration, regulations and service terms at quote approval. This reference supports budgeting; it does not supply a legal authorization, pesticide-use approval, personalized tax advice or guaranteed return on investment.
